This package of scope is the “crown jewel” on the $500m Prominent Hill Mine Expansion. OZ Minerals through ICN conducted an expansive search for suitable contractors so that they could ensure that this important structure was in the right hands. Most of the highly regarded and largest fabrication firms in the country were considered for this work, but OZM chose Bowhill Engineering to put their trust in! Why you might ask, well we’ll leave that to our client to explain.

Coordination – This structure due to the scale of the highly loaded mechanical equipment that it’s designed to support had to be robust and built to the highest standards. Each specific piece of mechanical equipment has loads that need consideration before design could be 100% finalised. With steel supply lead times at an all-time high, the circumstances created a difficult juggling act.



Bowhill worked with their suppliers to be very flexible with OZM through the designers, prioritising components that could be completed and delaying those elements that were affected by the absence of critical information, this was purely for the good of the project. This approach avoided over engineering, and minimised delaying the whole project even though the equipment specifications took longer than programmed.

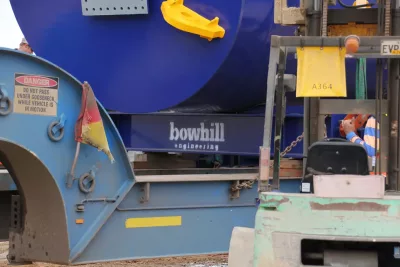

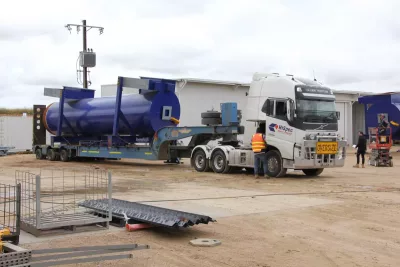

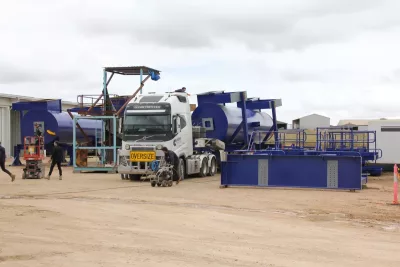

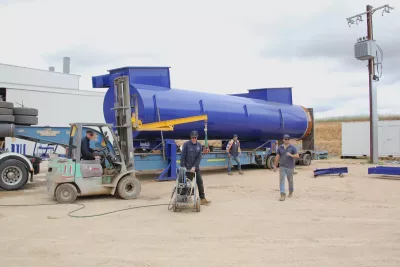

Erection surety – This structure is of large scale, the methodology chosen to erect was bold and necessitated a large crane and significant set up and planning. The Prominent Hill site is remote, it’s 700km north of Adelaide so getting a 900t crane to site comes at a premium. Any nasty surprises on site would be prohibitively expensive and a risk that required significant rigour in management. The 450t – 22mx22mx20m h module, complete with much of the mechanical equipment, is hoisted 40m from the ground to land on 4 raker columns each 2.5m diameter. Whilst the site works is not in Bowhill’s scope, the process requires that the brave riggers and welders scale the structure and complete a full site butt weld of the 4 columns at 40m high!

Safety in design – The safety of the erection crew is of paramount importance and many novel solutions were uncovered. Temporary access to the weld splices were provided via steel access platforms that were fixed to the columns, tapered alignment guides in the joint ensured that alignment and root gap were accurate to shorten fit up time and to keep people away from crush zones.

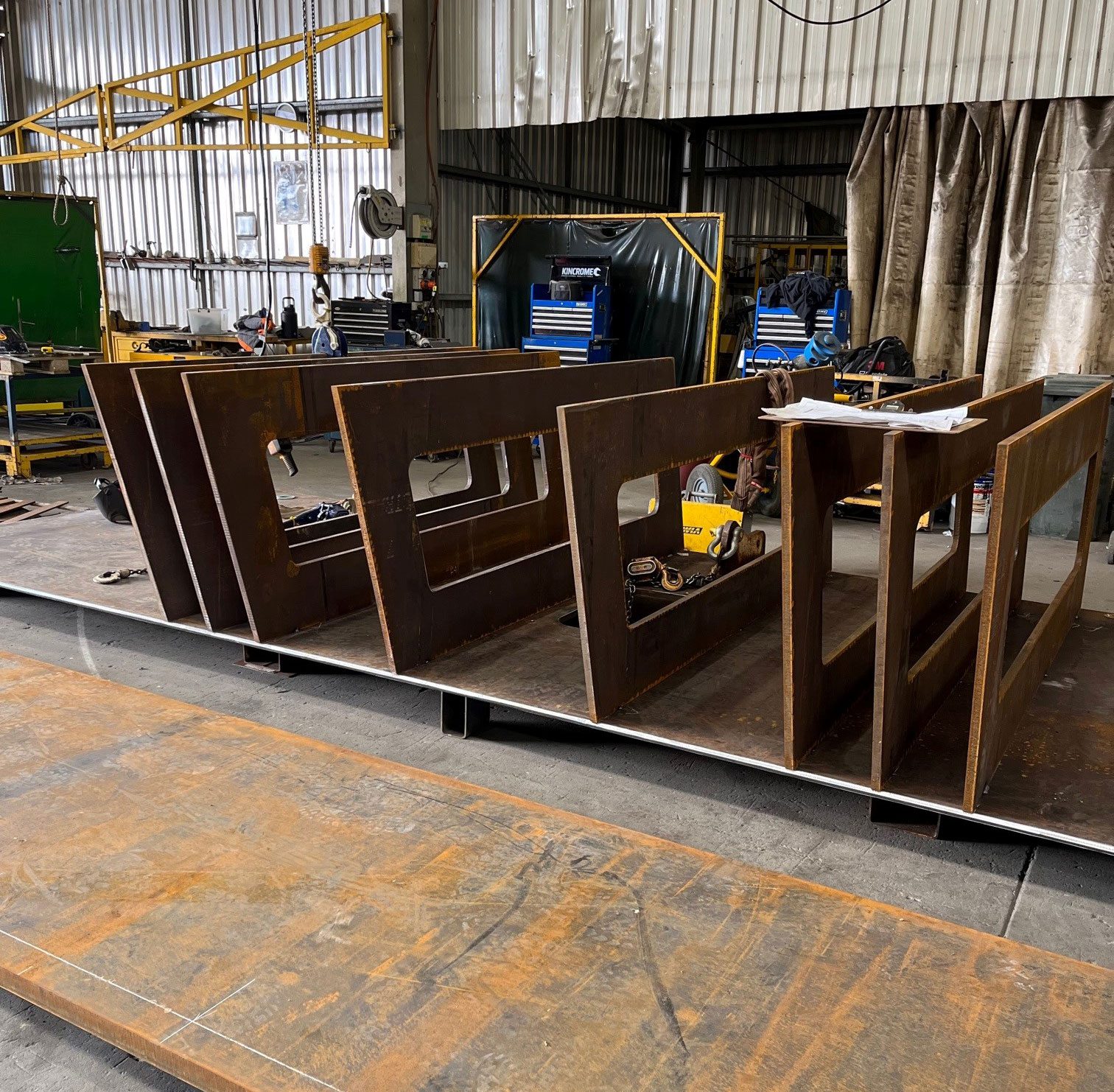

Accuracy – the scale of the structure made full shop assembly impractical, however because the accuracy was so important, it was decided to do a partial assembly and full point cloud laser scan which was transposed over the 3D model to identify the true asbuilt accuracy. This gave the whole team confidence that the fit up on site would go smoothly. “Could you imagine if we sent all the elements up to site and something didn’t fit! The cost to program as well as commercially would be horrendous. It’s not the sort of structure where you can just slot the holes and fit it up, it’s got to be of the highest precision” Jeremy Hawkes MD Bowhill Engineering.

Bowhill Engineering fabricates heavy and complex structural steel for mining, infrastructure and transport projects across Australia. Contractors bring us in early to help with design and sequencing. We then take the work through fabrication, welding and surface treatment at our own facility.

Our roots are in the Murraylands, South Australia. We have been a family business since the 1970s.Our team includes boilermakers, structural welders, metal fabricators, CNC operators, robotic welding specialists and project managers. Apprentices learn their trade alongside them.

  • Heavy mining structure fabrication, built to support highly loaded mechanical equipment
  • Flexible project coordination with suppliers and designers when steel lead times are long
  • Access platforms and alignment guides designed into the structure to protect erection crews
  • Partial assembly and point cloud laser scanning to check accuracy before delivery to site
  • Structural components from 5 tonnes up to 140 tonnes, supported by overhead cranes up to 100 tonnes
  • Certified to AS5131 CC3, ISO9001, AS4801, ISO14001 and Weld Australia AS3834.2
  • Major infrastructure delivered nationally, including 6,600 tonnes of tunnel segments for Torrens to Darlington
  • A strong safety culture and environmental compliance on every project

We invest in our people, our capability and our regional community to build the structures that matter.

Other Projects and Solutions

We have delivered heavy structural steel for major projects across Australia, including:

  • Riverland Pump Station: a 35 metre structural steel structure on the Murray River, sequenced for restricted site access
  • Flinders Link Steel Bridge: 20 open top box girders, with our in-house modular sand jacks for safe installation
  • KI Ports Temp Steel: temporary steelwork for crane and piling access, with around 80% of the steel repurposed

After going out to the market in the search of suitable contractors for this significant structure, we were pleased to find Bowhill Engineering. Their bid was compelling not just in terms of price, but especially in their ability to meet the RFQ’s evaluation criteria. Since awarding them the contract we have built a solid relationship and have been very impressed with the work they are doing and the way they go about their business

Eric Downing | Project Director – Prominent Hill

Project Details

Project Description: The Prominent Hill Mine Expansion is a $500m project for OZ Minerals. This mining headframe was a key package of that work. It had to support heavy mechanical equipment, so it was built to the highest standards. The structure is a 450 tonne module, 22m x 22m x 20m high. It was hoisted 40m onto four raker columns, each 2.5m in diameter. The site is 700km north of Adelaide.
